Public Works

2024 Bridge Repairs

2024 Bridge Repairs

(Photo above: The Peshastin Bridge will be the only bridge in the project that will require a temporary full closure. The four-week closure begins June 17.)



Project Updates

Posted Sept. 15:  The project is now complete.



Project Description

In summer 2024, Chelan County will make repairs to five bridges around the county. Deck joints on all the bridges will be replaced. Two of the bridges will also receive new concrete overlays to the deck.

Expansion joints allow concrete bridges to naturally expand and contract. When replacing the bridge deck joints, a contractor will remove the existing concrete on each side of the joint and pour back with high strength concrete while also installing a new rubber seal in the joint. The roadway approaches to each bridge also will be repaved where the road and bridge end joints meet.

When pouring a deck overlay, the contractor will remove the top 1.5 inches of concrete deck and pour back 1.5 inches of new concrete.

The following bridges are scheduled for repairs:



Bridge Name Road Milepost Description of Work
Peshastin Bridge Main Street (Peshastin) 4.35 to 4.43 Overlay the bridge deck and replace the bridge deck joints (10 joints on the bridge and 2 end joints)
Ardenvoir Bridge Mad River Road 0.05 to 0.08 Overlay the bridge deck and replace the bridge deck joints (1 joint on the bridge and 2 end joints)
New Griffith Bridge Entiat River Road 3.91 to 3.98 Replace the bridge deck joints (2 end joints)
Chelan Falls Bridge Chelan Falls Road 0.64 to 0.74 Replace the bridge deck joints (4 joints on the bridge and 2 end joints)
Stone Hill Bridge Colockum Road 17.79 to 17.81 Replace the bridge deck joints (2 end joints)



Project Benefits

Bridge deck overlays extend the life of a bridge by more than 20 by replacing the damaged concrete with new concrete that protects the reinforcement steel from corrosive road chemicals such as de-icers. An overlay also provides a smoother ride across the bridge, which reduces impact damage from bouncing vehicles.

Joint replacements can last more than 10 years and protect a bridge deck from impact damage caused by bouncing vehicles. Joint repairs also keep corrosive chemicals from flowing off the deck and damaging the bridge piers and bearings.

Life span off all the repairs is dependent on traffic volumes, especially truck volumes.



Peshastin Bridge

Only construction on the Peshastin Bridge will require a temporary full closure of the bridge. The bridge is too narrow for a one-lane closure; its narrow lanes, sidewalks and guardrails leave little work space for the construction crew.

The four-week closure will begin June 17 and the bridge will re-open on July 13.

The detour route for Peshastin Bridge will utilize North Road, Chumstick Highway and Highway 2. See the links below for the detour map.

Detour Map/Ruta de Desvío

Community Presentation (October 2023)



Construction Schedule

Work on the Peshastin Bridge begins June 17 and the bridge will re-open on July 13.

Scheduled work on the remaining four bridges may occur during the Peshastin Bridge closure but is highly dependent on the contractor’s workforce, equipment and material availability.

The project is expected to be awarded in early April. A construction schedule will be determined with the new contractor. We will post the schedule when we have it available. All construction will wrap up in summer 2024.



Travel Impacts

With the exception of the Peshastin Bridge, the repair work will allow for one-lane, flagger-controlled traffic on the Ardenvoir, New Griffith, Chelan Falls and Stone Hill bridges. Motorists should plan for minor traffic delays when crews are working on those bridges.

See the traffic impacts included with the Peshastin Bridge four-week closure above.



Peshastin Shuttle Service

The closure of the Peshastin bridge from June 17 to mid-July will impact Link Transit’s Route 22, operating between Wenatchee and Leavenworth. There will be no access to Peshastin from Highway 2. To mitigate this, Link will operate a shuttle traveling on North Road between the turnaround in Peshastin to Wilkommen Park-and-Ride, behind Safeway. The bus stop at the Peshastin Library will not be served by this shuttle.

The shuttle will operate seven days a week, with a reduced schedule on Saturdays and Sundays. Connections into Wenatchee or into Leavenworth can be made at Wilkommen Park-and-Ride, on either the Route 22, Route 122 or the Leavenworth DART (serving the greater Leavenworth area only).

View the full shuttle schedule on the Link Transit website. For questions about the shuttle service, call Link Transit directly at 509-662-1155.



Funding

The project was awarded to N.A. Degerstrom, Inc., for $2,057,740. The project is fully paid for with federal grant dollars from the Washington State Department of Transportation. The project is projected to cost $3,635,000 for both design and construction.



Receive Project Updates

Project updates will be posted to this page once construction has started. You can also sign up for updates via the county’s e-newsletter or follow Chelan County Public Works on Facebook. If you have questions during construction, email the public information officer at jillm.fitzsimmons@co.chelan.wa.us.

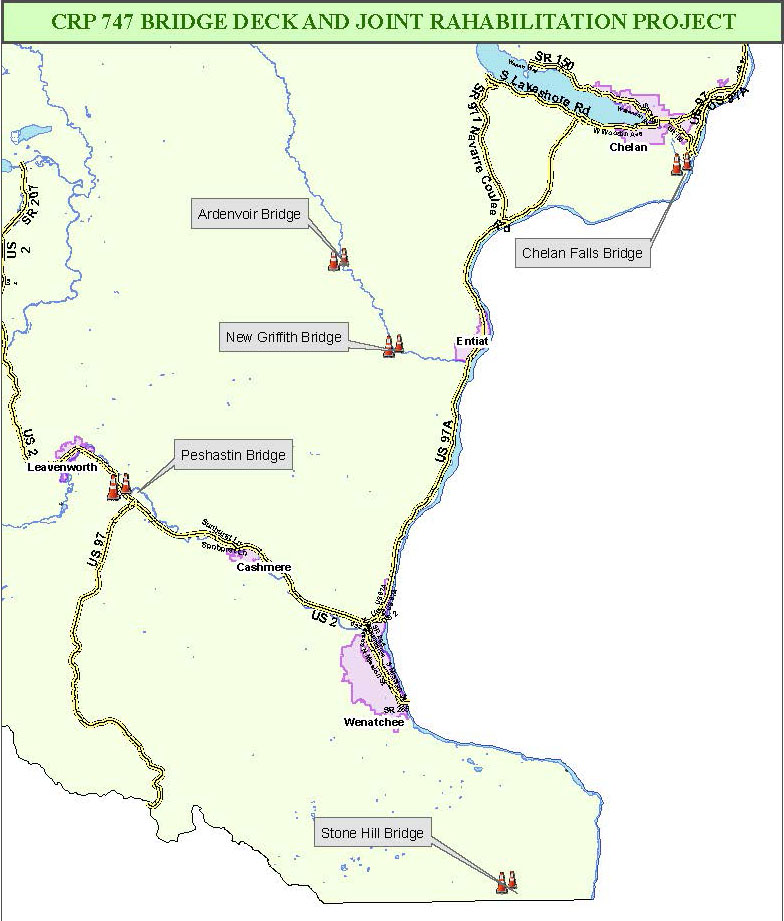

Map

Posted: 04/02/2024 11:14 AM
Last Updated: 09/15/2024 11:46 AM
